11. 5th November 2012 We start on site
Monday
The CamPlant boys arrived at 8:30 and fired up the machinery. All day there has been the sounds of demolition and destruction. Two machines in full power, one knocking down and the other grinding up anything that will form good hardstanding.
The CamPlant boys arrived at 8:30 and fired up the machinery. All day there has been the sounds of demolition and destruction. Two machines in full power, one knocking down and the other grinding up anything that will form good hardstanding.
By midday half the house was down and
by 4pm the only piece remaining was the site office, the wc and the coal bunker
that now houses my tumble drier.
Max has been separating anything that
can be reclaimed either as useful timber or fire wood for the future.
The timber forms one pile, the other
pile is concrete which will be reduced to rubble – then we will have a clean
site for setting out the new house. What
a milestone in the calendar. I’m not
sure whether less than two years ago (Jan 2011) when we first decided this
building lark was for us, we really believed it would happen.
We are houseless. No turning back.
Things are from this point on serious.

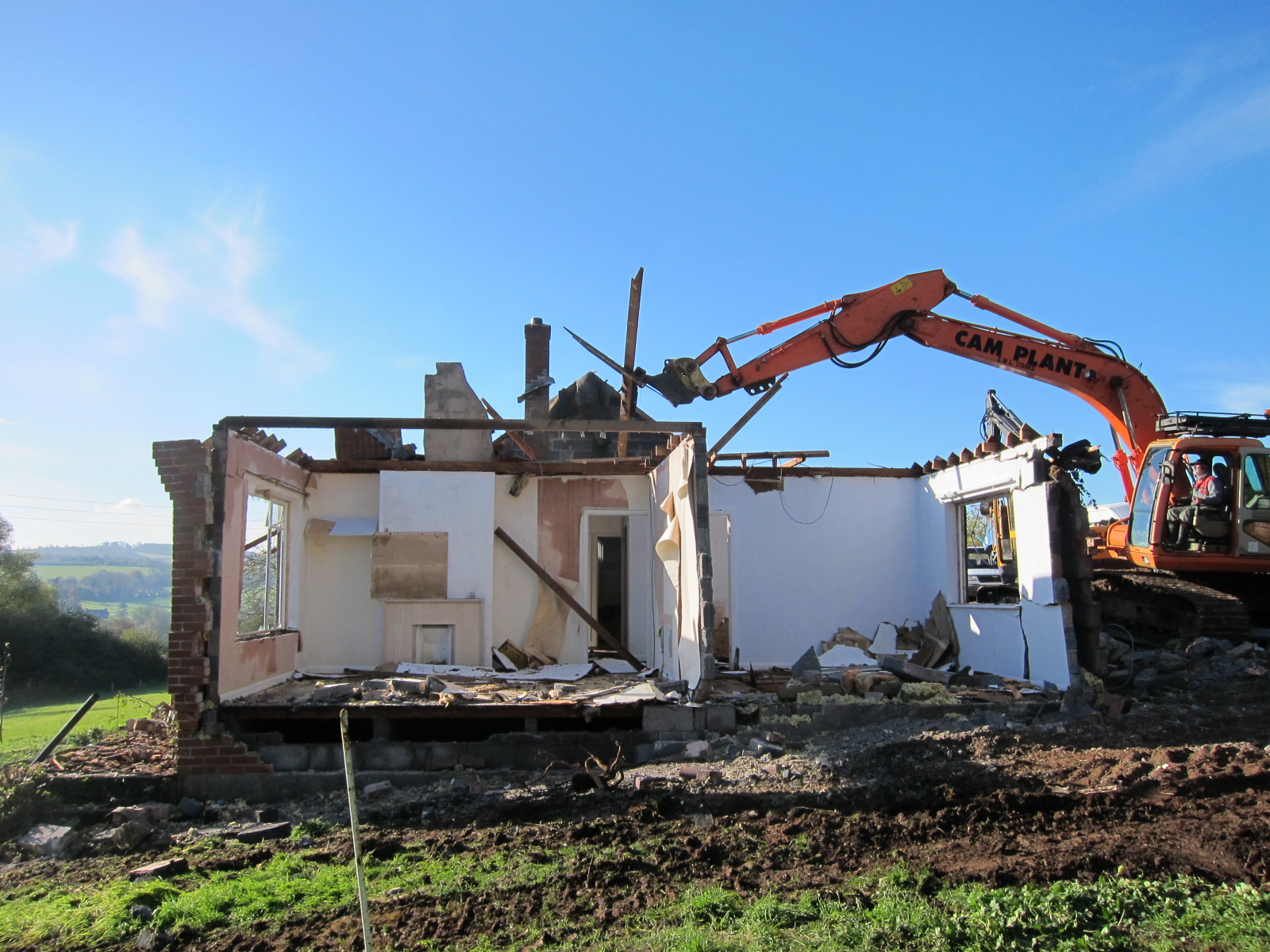

Stephan making sure he knows exactly which direction Max wants him to go |
Demolition underway |
The sun decided to shine on us for our first day, after waking up to snow the day before! Stephan was able to pick off the timbers with great accuracy. |
Stephan could very delicately remove the timber |
It very soon became a pile of rubble |
All the blocks were crushed and ground down into suitable hardcore to provide a good standing for the lorries that will be coming to the site |
Any unwanted combustible material was burnt. Best bonfire in the village. |
The site office being reduced to the minimum size needed on the site. The last bit of wall being struck off with great delicacy. |
The site office and wc |
Hardcore from the bungalow providing substantial access around the site |
Congratulating each other on a job well done |
Jake contemplating the view with a well deserved cuppa |
All that was left the following morning |
Good
news about the windows. We had a call
from the window fabricators, as promised, and they are going to commence
drawing up all the windows in line with the architect’s specifications and
measurements. This was then followed up by a call on Thursday to say that they
had had a conversation with another company who are prepared to fabricate the
windows as specified and supply them through our fabricators. We just have to wait and see that the price
remains within budget. It will be 2 or 3
weeks before we know the score. But it
looks hopeful.
Wednesday
The
site is now clear, house gone, different materials sorted and dispersed, the hard
stuff crushed and used as hardcore to provide a hard-standing for all the
lorries coming to the site, The glass
has been removed and will be taken to the recycling plant.. Much wood has been
reclaimed, metal work is to be taken for scrap and the reward shared between us
and Stephan, anything combustible and without use has been burnt on a grand
bonfire.
The
timber we have kept is really good quality – the roof joists and beams are in
excellent condition, and Max has already made shelves for the container unit so
that we can store his tools and equipment securely – and he can find what he
needs without having to empty the store each time.
We
have also built a wind break on the weather side of the caravan awning, so that
if we have torrential rain and storms, it is less likely to take flight and fly
away towards Islington. If it did, I might try and hang on tight. No, no, not really, I like it here.
Because
the site is now all clear we are in a position to create the starting level –
shown on the architect’s drawings as the Excavation level and plot where the
house sits on the site. We have 4 posts
which were originally positioned when I decided to reorientate the house by 9˚
if you remember. From these points we can
plot the outline accurately.
Having
set the key reference points, Stephan moved in with his big machine and used
his tripod leveler to beep at him to signal that he was scraping the ground at
the correct level needed to create the required ‘excavation level’.
There
are two excavation levels one corresponds to the entrance hall, the snug, my
office, and Max’s studio, the lower level corresponds to the kitchen, dining
and living room.
From
the excavation level we then dig ‘down’ for the foundations and then build ‘up’
to create the slab and finished floor level and the rest of the house.
Levels
from now on are critical, so are right angles and verticals, not to forget
those all important Pythagoras diagonals.
I will be watching dimensions like a hawk.
On
Wednesday we received the results of the Radon test that all new buildings have
to have done. Radon is a colourless, odourless radioactive gas. It is
formed by the radioactive decay of the small amounts of uranium that occur
naturally in all rocks and soils.
Although not entirely necessary, we have been advised that Building Regulations require us to include a slightly thicker dpm. They would I suppose. Health and Safety ticking all the boxes. OK, so not a bad result, and little to complain about really.
Although not entirely necessary, we have been advised that Building Regulations require us to include a slightly thicker dpm. They would I suppose. Health and Safety ticking all the boxes. OK, so not a bad result, and little to complain about really.
Friday
Today
the surveyor came to plot the gridlines for us.
As he marked the lines, Max rapidly made the profile boards that are the
markers you see on any building site – 2 uprights with a horizontal board
across. The surveyor positioned a nail
on the top of the horizontal board to mark the grid. A aligns with A; B with B, letters in the
north south direction, numbers east west direction. Then we stretch a line of string between the
corresponding letters or numbers and we sprayed the lines so we have a grid painted
on the ground of the site. The grid
lines basically indicate the centre of key walls or lines of steel columns in our
case. They also indicate the centre of
the footings so that we can mark the trenches for Stephan. Some of the trenches need to be 900mm wide,
some 600mm and the steel pads 1200mm.
The trenches are of different depths so we need to mark this out for Stephan
also.
First lines marking out the footings |
Our very serious surveyor plotting the gps coordinates that mark accurately the buildings location on the site |
A
long day, but we completed the task.
Next
week we will be digging the footings, meeting the building control inspector
who will either give us the green light to pour the concrete, or demand a whole
lot of amendments, additions, before he allows us to carry on. All being well, the concrete will be poured
Wednesday or Thursday and the surveyor will come back the same day to position
the holding down bolts (exactly) for the 19 steel columns. Actually we are unable to pour the concrete
in one session as the footings are too complicated for that. Max and I have been planning the sequence of
pours this evening. We think we can do
most of it in one day, with a second pour to connect all the separate lengths
early the following week. We will have
to make a number of drainage channels with special shuttering and lintels,
which will need time without pressure.
Next week is going to be one of the most demanding for us.
I hope to take some photos tomorrow to show all the lines that Max and I have drawn on the site this weekend to plot the footings prior to Stephan digging them out tomorrow.
If all goes to plan you should see photos of some of the concrete footings in place by next weekend. . . . . Weather looks pretty good.
If all goes to plan you should see photos of some of the concrete footings in place by next weekend. . . . . Weather looks pretty good.
